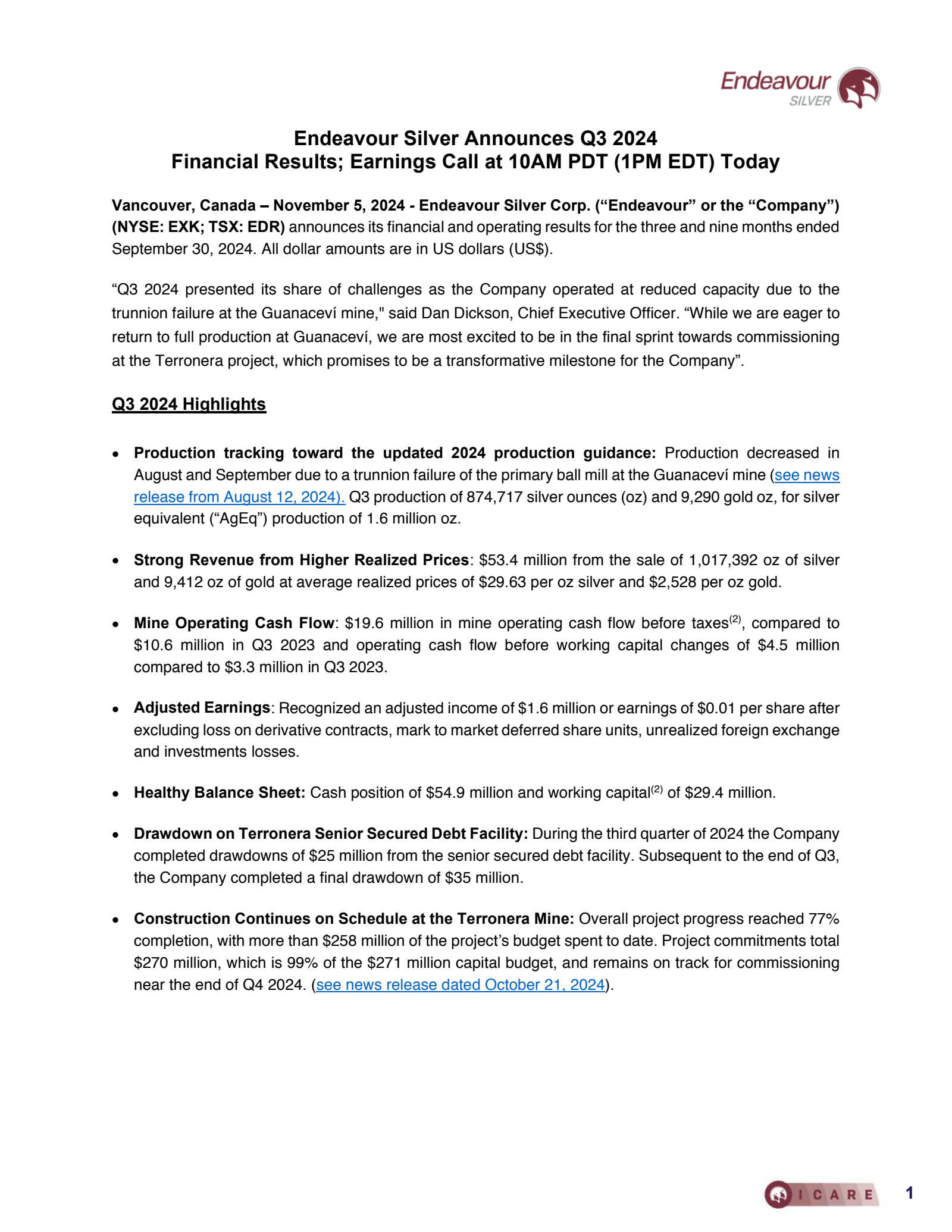

Endeavour Silver Q3 2024 Earnings Call Transcript

There are 9 speakers on the call.

Operator

Thank you for standing by. This is the conference operator. Welcome to the Endeavour Silver Corp. 3rd Quarter 2024 Results Conference Call. As a reminder, all participants are in listen only mode and the conference is being recorded.

Operator

After the presentation, there will be an opportunity to ask questions. I would now like to turn the conference over to Alison Pettit, Director of Investor Relations. Please go ahead.

Speaker 1

Thank you, operator, and good morning, everyone. Before we get started, I ask that you view our MD and A precautionary language regarding forward looking statements and the risk factors pertaining to these statements. Our MD and A and financial statements are available on our website at edrsilver.com. On today's call, we have Dan Dickson, Endeavour Silver's CEO Elizabeth Sines, our CFO and Don Gray, Endeavour's COO. Following Dan's formal remarks, we will open the call for questions.

Speaker 1

And now over to Dan.

Speaker 2

Thank you, Alison, and welcome, everyone. It's been a busy Q3 at Endeavour Silver. As gold reached new all time highs and with silver starting to follow, the company's cash flow and financial position should continue to benefit from these higher prices. From an operational standpoint, Q3 brought an unexpected challenge as the company operated at reduced capacity due to a trunnion failure of the primary ball mill at the Guanace City mine. Temporary modifications were completed in August, allowing processing to continue at roughly 50% of capacity.

Speaker 2

The estimated time line back to full capacity remains at 15 weeks with the mine being in full operation next month. I would like to extend my thanks to our operations team for their dedicated efforts in mitigating the issue. Q3 silver equivalent production totaled 1,600,000 ounces or 875,000 ounces of silver and 9,300 ounces of gold, tracking well towards the updated 2024 production guidance of 7.3000000 to 7,600,000 silver equivalent ounces. Silver equivalent grades have been in line with expectations, with gold grades slightly higher and silver grades slightly lower. This is expected to be similar going forward, and we expect the production profile in the Q4 to be similar to Q3.

Speaker 2

At Terronera, substantial progress was made during the Q3. Surface construction reached 77% at September 30, with more than $258,000,000 spent today. The finish line is in sight as Terronera continues to remain on track for commissioning near the end of the year, and we are excited to have this transformative project added to our production profile in 2025. Moving to our financials. We reported top line revenue of $53,000,000 up 8% year over year, benefiting from the higher precious metal prices compared to Q3 2023.

Speaker 2

Cost of sales totaled $41,000,000 a decrease of 12% compared to Q3 2023, driven by lower silver ounces sold in the quarter as well as cost management measures undertaken at Guanacevi following the trunnion failure, which also includes the termination of a third party contract mining activities. Direct operating costs on a per ton basis and a per ounce basis were elevated due to the reduced operating capacity at Quanta City. Because of the reduced operating capacity, management withdrew cost guidance for 2024 in August. The company reported a net loss of $17,000,000 for the 3 month period ended September 30, 2024 compared to a $2,300,000 loss in Q3 of 2023. Excluding certain non cash and unusual items and items that are subject to volatility, which are unrelated to the company's operations, adjusted income was $1,600,000 compared to an adjusted loss of $8,300,000 in Q3 2023.

Speaker 2

As of September 30, the company's cash position was $55,000,000 and working capital was $29,000,000 During the quarter, the company completed drawdowns of $25,000,000 from the senior secured debt facility for Terronera. And subsequent to the quarter, the company completed its final drawdown of $35,000,000 As I mentioned earlier, the overall progress at Terronera reached 77% with more than $258,000,000 of the project's budget spent to date. Project commitments totaled $270,000,000 which is 99% of the $271,000,000 capital budget and remains on track for commissioning near the end of Q4 2024. During the Q3, 1050 meters of underground mine development was completed for a cumulative total of 5,550 meters and the team continued progressing Portals 1, 2 and 4, with long hole stopes being developed and initial production planned for Q4. The underground explosive magazines were also completed with the explosive use permit application submitted for approval and anticipated in the New Year.

Speaker 2

On the upper platform, surface mill and infrastructure construction is 90% complete and continues to transition to operations. The Core Store stockpile and reclaimed tunnel reached 100% completion with pre commissioning testing beginning in the Q3 and the primary jaw crusher was commissioned with Rock in August, marking a major project milestone. The excavation of the tailings storage facility embankment key trench is 100% complete with the secondary key at 40% complete. Structural steel columns and beams were erected for the concentration filter building and equipment mechanical structures and remain on the critical path for commissioning in Q4. Through September 30, procurement was 99% complete and the project team continues to expedite pending arrivals.

Speaker 2

And lastly, from a community relations standpoint, with local community support continue to be a major commitment, in Q3, the company supported a series of local initiatives and investments such as the inauguration of an early childhood development center, scholarships for university students in Santiago Stojtinos, municipal road maintenance, workshops for business entrepreneurship for local residents, environmental education programs for primary schools, community tree donations and summer community workshops for children and youth. For a fulsome construction update at Terronera, I encourage you to visit our website where you'll find our quarterly photo gallery showcasing the latest developments, progress and information. With that, I'm happy to open up to questions. Operator, please proceed to our Q and A session.

Operator

Our first question is from Heiko Ihle with H. C. Wainwright. Please go ahead.

Speaker 3

Hey, Dan and team, I assume you guys could hear me okay?

Speaker 2

We can hear you really well, Heiko. It's nice to hear from you.

Speaker 3

Perfect. I was going through your October 21, October 21 press release regarding Piranera earlier today again. Just a few follow ups from the release, you hinted at a few of them earlier on this call. You mentioned that you're recruiting and training team members. How many folks are currently on the payroll?

Speaker 3

And can you maybe give a trajectory for staffing levels with the timeline from now until full employment at the site?

Speaker 2

I can tell you that full employment at the site when we're in operations is about just over 500 people. Currently, we're well over 7.50 people at site. In fact, we have a second shift coming to help push us to the end of the year here with regards to our tailings filter press. As far as the ramp up of where we're exactly right now compared to where we're right now compared to where we're going to be when we're in full operations, I think we have about 2 50

Speaker 4

Endeavour Silver employees. And

Speaker 2

I think there's actually 800 contract workers on-site trying to push to get us to the end here. So,

Speaker 3

impressive numbers. Building on all of that, and again, you had some talking points that preempted some of this in your prepared remarks. Are you seeing community embracement from all of those? I mean, there is still a decent amount of local job creation from all of this. What are you seeing?

Speaker 3

Can you maybe give some examples of and obviously, you're doing the scholarships and you're doing all sorts of stuff. Is it working? Are they embracing it?

Speaker 2

Yes, I'll touch on a bit, maybe pass it to Don, who's outside a bit more than I am. But ultimately, we've had a community relations group on-site since 2013 when we really acquired the property. And I got to hand it to our explorations team that's done a phenomenal job of incorporating things that would help the community benefit from our mine and ultimately incorporating them with understanding what we're doing at Turner. I'd say over our last 4 or 5 years, we've had great engagement with the community. I think Santiago de los Pinos will benefit greatly, and I think they're greatly involved.

Speaker 2

We've hired people there and ultimately brought a lot of direct and indirect jobs to the community. As far as the programs that we have, and it's similar to what we've always done at Guanacevi and Bolanitos, I mean, we feel like we're neighbors and to be a good neighbor, you got to be part of the community and help out where we can. Obviously, I touched on some in my talk with tree donations, community support for various days like Day of the Dead. We're always involved with that and we're always looking ways to kind of incorporate ourselves in the community because obviously having a social license to operate has been a foundation of endeavor and I think that's going to continue to be the case. Don, I don't know if there's anything else you want to add or other community programs that we're doing that you see has been greatly beneficial?

Speaker 5

I think I mentioned on our we have a phased training program for our mill operators and many of the people in the area don't have experience and so we're bringing them in for early training. And when we first started the program, we had a few vacancies in there and then as the word got around that the training was good and the company was serious, we filled out all the slots. So I think that's a real tribute to our guys putting together good programs and working with the community.

Speaker 3

Very good. And then just completely different follow-up on something else. Can you give some color on where we should model G and A for the remainder of the year and maybe even 2025, assuming the share price stays where it is, given the revaluation of the DSU liabilities, the cash settled one that you encountered this quarter, please?

Speaker 2

Yes. No, for sure. I'm not going to get too much into 2025, but ultimately, if you look back at the history of Endeavor, our G and A from a cash perspective has always been about $8,000,000 to $10,000,000 And then you can put in the DSUs and mark to market on DSUs or stock based comp. I don't know why our G and A would ramp up significantly in 2025 compared to 2024. And I believe we're tracking right along those lines of $8,000,000 to $10,000,000 in cash G and A.

Speaker 3

Very good. I'll get back in queue. Thank you so much.

Speaker 2

Thank you, Eiko, for the questions.

Operator

The next question is from Lucas Pipes with B. Riley Securities. Please go ahead.

Speaker 6

Thank you so much, operator. This is Nick Giles asking questions on behalf of Lucas. Dan and team, congrats on all the progress at Terronera so far. Maybe a question for both Dan and Don. Just would love to get a little bit more color about the ramp process, how to think about timing and ultimately what would you consider the largest potential bottlenecks during that process?

Speaker 6

Thank you very much.

Speaker 2

Thanks, Nick. I can help out a little bit with Don. Ultimately, we expect kind of a 3 month ramp up. We're hoping to go a little bit quicker, and I'll leave it to Don what he expects the bottlenecks can be, but I'm sure there's many that come through his head.

Speaker 5

Ed? Yes, I mean it's normal. You have the normal startup items and we do have much of the upper platform completed. So there's a lot of things we can get pre checked in advance. Where we'll have the focus is on the especially on the concentrate and the tailing filters there.

Speaker 5

We want to get one circuit up and running real well and then we can complete a lot of the commissioning. So our focus will be there and we feel we brought in the right talent, have the vendor support. So we think it will go along as planned.

Speaker 6

Don, that's great to hear. I appreciate the color. Any updated view on cash costs or on sustaining just based on current gold and silver prices?

Speaker 2

Yes. I'm guessing, Nick, you're asking for 2025 related to Terronera?

Speaker 6

That's correct.

Speaker 2

Yes. Where our plan will be as we get into commissioning to ramp up, we'll come out with 2025 guidance early next year. Ultimately, our feasibility study that came out in 2021, we updated that in great prior to start the build or ultimately making our investment decision. And our cost per tonne at the time was $81 and we fully understand that we've seen a lot of inflationary pressures over the last 2 years, and we've seen that at our existing operations, corn and sea and Bolanitos. As we get into going through all our budgeting and make sure our cost driver is right, It will take a little bit of time and we want to make sure we understand all the numbers and then the timelines to come out with that.

Speaker 2

So you can bear with us. We expect them to come out, like I say, in January, February of next year.

Speaker 6

Fair enough. No, I appreciate that. And if I can squeeze one more in, maybe a question for Elizabeth. It would be great to get your perspective on target liquidity, cash on balance sheet, just as Terronera reaches full run rates?

Speaker 1

Yes. So as you saw at the end of September, we had $55,000,000 in cash. And then obviously during the month of October, we've been continuing to build Terronera. But what we're seeing is that a lot of the deposits that were made in advance with our vendors are now being applied to our activities. So the cash burn at Terronera has been slowing down.

Speaker 1

So we do anticipate a smooth cash position as we move into 2025 and start that ramp up process and see cash flows coming in at Terronera early in 2025.

Speaker 6

Great. That's super helpful. Dan, Elizabeth, Don, to you and the rest of the team, continue best of luck. Thanks so much.

Speaker 2

Thanks, Nick. Good questions.

Operator

The next question is from Nicholas Clark with TD

Speaker 4

Cowen. Nick Clark here asking on behalf of Craig Hutchison. Just one question, if I could circle back on Terronera and maybe this is just a little more clarification. But if we're looking at about 99% of that $271,000,000 budget being committed currently, would it be fair to kind of think about remaining 23%

Speaker 2

left on

Speaker 4

a fiscal completion as being covered by those commitments or would there be a little bit of a delta there? Thank you.

Speaker 2

Yes, I'm happy to answer that. I mean Libby and Don are sitting right now in Mexico. Ultimately, the $270,000,000 committed and the $258,000,000 spent, the $258,000,000 spent includes prepaids and advances that Libby touched on with Nick's, Giles' question there. Ultimately, with what's left, and it's a very dynamic question because we have a lot going on with regards to our LNG vaporization plant. Ultimately, we've been staying in the market that's going to be ready in 2025.

Speaker 2

We're open by the end of the Q1, but we could ultimately be in commercial production before that's completed. We have an embankment on our tailings dam. Originally, it's estimated to be $40,000,000 net $271,000,000 We think we can start up with a slower embankment. Of course, we are trying to hit what our percentage completion was or actual expectation and then mine development. And depending on that commissioning timeline, it's difficult.

Speaker 2

But we do know we're in the ballpark. We're not coming out with a commitment of exactly what our spend will be, but we're on good track right now. Got it. Okay. Thank you.

Speaker 2

So just to clarify, if you look at

Speaker 4

77% of $271,000,000 that's around $209,000,000 but that is not suggesting that you guys are $50,000,000 off of where you're hoping to be?

Speaker 2

Correct.

Speaker 4

Great. Thanks, guys.

Operator

The next question is from Jake Sekelsky with Alliance Global Partners. Please go ahead.

Speaker 7

Hey, Dan and Seem. Thanks for taking my questions.

Speaker 2

Happy to take your questions, Jay. So can you just provide a bit of color

Speaker 7

on the return to steady state at Guanacevi, maybe on the timing and any hiccups you think you might encounter getting back to more normalized levels?

Speaker 2

Yes, I'll have Fili pass that to Don.

Speaker 5

I think as Dan mentioned in the opening comments, our operating team did a really good job working on the milling circuit and keeping that going. And also they've done equally as good a job on the repair work, maintaining close contact with the foundry because we did have to have some things put together and that's continuing like we planned. So I think we're in good shape. We have the contract lined up for when the parts get there and the components and we don't expect any glitches there.

Speaker 7

Okay, that's helpful. Then just in a broad sense, with where precious metals prices are, I'm just curious, has that caused you guys to revisit any of the near term or medium term mine plans or how you're looking at the milling at Guanacevi?

Speaker 2

Yes, I mean, that's a good question. It's something that we look at every year. It's that time of the year right now, budgeting the mine plans and finalizing those for next year. And I would say even at Terronera, it's a dynamic with where prices are. And obviously, in our resource models, we have indicated ounces, we have inferred ounces.

Speaker 2

And often, we, as Endeavor with our underground mining, have brought in inferred ounces and indicated ounces into the mine plans. Sometimes potential ounces aren't even in our resource. With higher prices, it allows us to go in some areas that we may be abandoned in the past. And again, we're going through our resource update for 2024, year end 2024 and we'll come out with that probably in our MD and A or our information at our AIF ultimately for year end.

Operator

The next question is from Steven Sook with Stifel.

Speaker 8

Congrats on a good quarter despite some operational challenges. So kudos to all of you. Just wanted to ask about the underground at Terronera. Has there been any test mining or update on how the ore body and or ground conditions look compared to expectations now that you're well into it? And maybe just kind of as a follow on, how comfortable are you with the amount of underground development established now that we're just ahead of the start of production?

Speaker 2

Great question, Steven. I'll let Don respond. Okay.

Speaker 5

So we are we have developed an area to do a test stope. We're actually close to beginning some blasting in that stope and extracting the ore. The good thing is that area, it will be a long hole stope in that area originally in the feasibility, it was cut and fill. And we have seen ground conditions in the mine better than what in the veins, better than what we anticipated from the feasibility study. So we've been looking at that, doing a lot of rock mechanics work and feel there's some upside there.

Speaker 5

For the development, because we are finding more areas for that will put in the mine plan as long hole stoping, that just takes the pressure off of so much development to get the cut and fill stopes ready. So we'll be in good shape.

Speaker 8

That's great to hear and hopefully continues. I know that have really positive implications on your ASIC number if you're able to cut down that life of mine development through more long holds. So that's great. Maybe just on a bit of a different note, can you just give us a quick update on what's happening at Piteria? And maybe just what to look forward to there through 2025 at a high level?

Speaker 2

Yes, it's a great question actually, Stephen. Ultimately, which was in our original guidance for the year, we're going to spend about $5,000,000 at Pitria advancing an underground ramp that we had towards what's called our Manto zone. And then we feel like there's some feeder structures there. So we've been drilling there for the last almost 3 months and we should have news out on pizzeria in the coming weeks to push that forward. Ultimately, we really believe in what we have at pizzeria.

Speaker 2

We think ultimately what we purchased 2 years ago from SSR Mining is a special asset. For those that aren't familiar with pizzeria, we have 600,000,000 ounces of silver defined plus zinc and lead. Ultimately, we've been looking at Pithoria as an underground operation or potential for an underground operation. And like I say, we should have some news out on that in the next couple of weeks. So great timing for that question, Steven.

Speaker 8

Perfect. Well, I'll stay tuned. That's it from you guys. I appreciate the color.

Speaker 2

Thanks for the questions.

Operator

This concludes the question and answer session. I would like to turn the conference back over to Dan Dickson for any closing remarks.

Speaker 2

Thank you, operator, and thanks for everyone attending our Q3 financial call. Like I said at the beginning of our call today, it was a bit of a challenging quarter with the trunnion. I think our operating team did a phenomenal job to mitigate that as best we could. Terronera continues to be on track, and we're excited to see what Q4 and 2025 brings for the company. Thank you, everyone, for attending.

Operator

This brings to an end today's conference call. You may disconnect your lines. Thank you for participating, and have a pleasant day.
